Property Notifications and Spalling Update
UNITS CURRENTLY UNDER REMODEL:
Unit 270
10/28 - 11/3: Drywall / Tape / Smooth Finish / Moderate Noise
11/4 - 11/5: Floor Preparation / Install Flooring Underlayment / Moderate Noise
11/6: AOAO to Inspect Sound Membrane
11/6 - 11/30: Tile Saw Cutting / Moderate Noise
11/1 - 12/20: Install Cabinets / Countertops / Interior Doors / Mirrors / Moderate Noise
12/14 - 12/20: Final Cleaning / Detailing / Quiet to Moderate
Unit 824
10/28 - 10/31: Tile Saw Cutting / Moderate Noise
11/1 - 11/14: Install Interior Doors and Shower Glass / Moderate Noise
11/14 - 11/15: Final Cleaning / Detailing
11/15: AOAO Final Inspection
Unit 1011
10/28 - 11/1: Tile Saw Cutting / Moderate Noise
11/1 - 11/21: Install Cabinets, Countertops, Interior Doors and Mirrors / Moderate Noise
11/22: Final Cleaning / Detail / Moderate to Quiet Work
11/22: AOAO Final Inspection

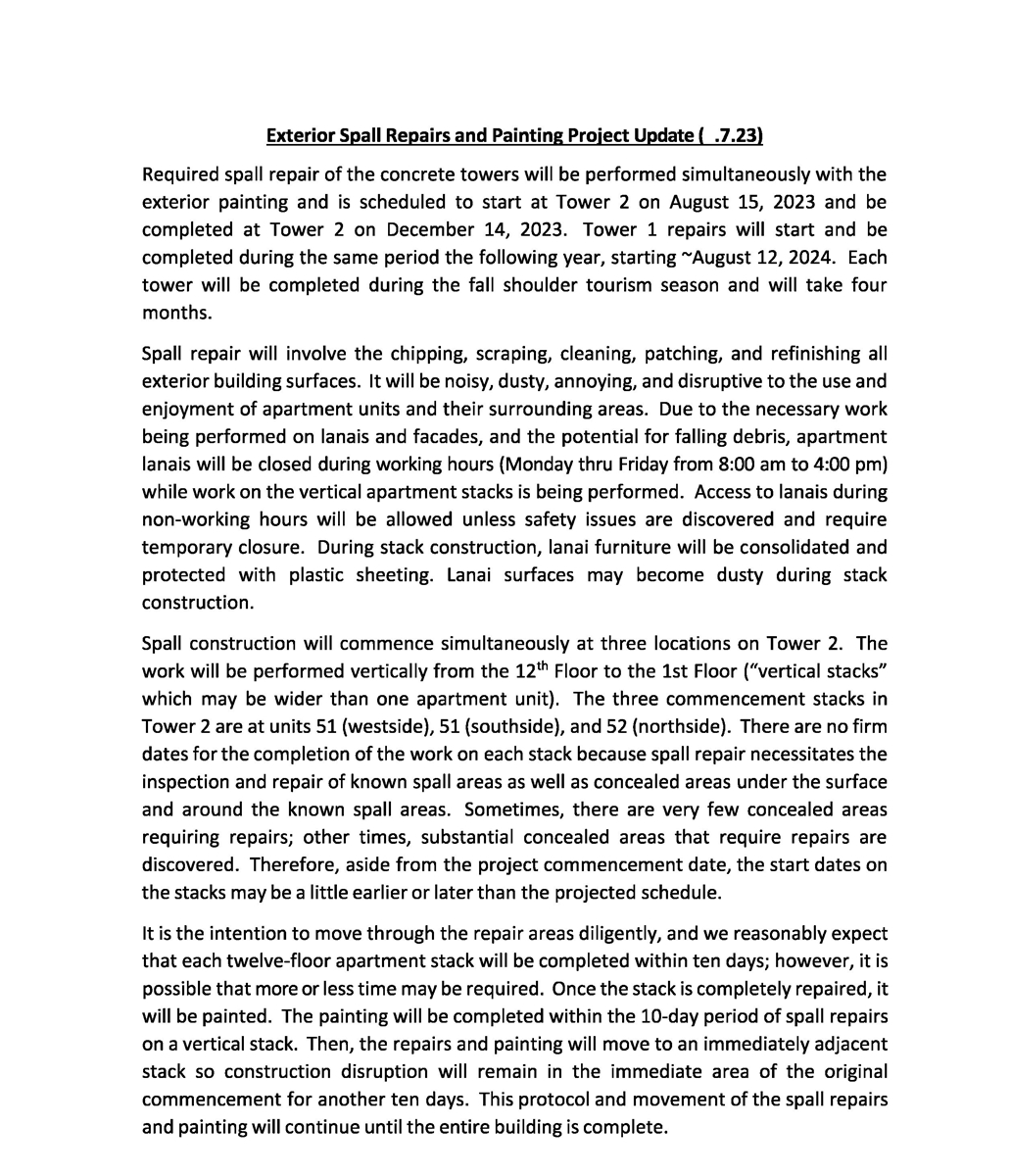

Spalling and Painting Project - Tower 1
August 2024 thru March 14, 2025
Units in Tower 2 will not be affected. However there will be scaffolding in various locations around
Tower 1. Work hours are Monday - Friday 8am - 5:30pm, and weekends if needed. There will be no noisy work during the Holiday Period of December 21 thru January 3. There may be quiet work, but should not be disruptive.
Tower 1. Work hours are Monday - Friday 8am - 5:30pm, and weekends if needed. There will be no noisy work during the Holiday Period of December 21 thru January 3. There may be quiet work, but should not be disruptive.

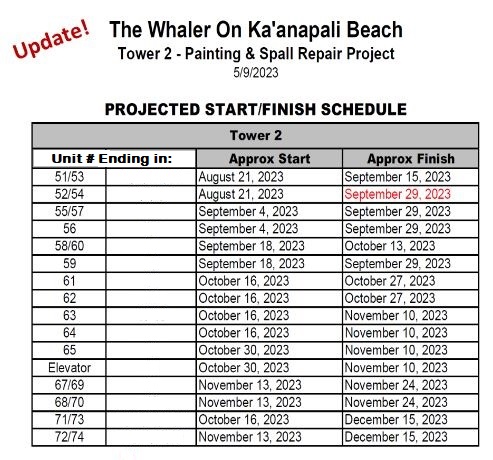

On the schedule below, "Stack" refers to the last 2 digits of the room number being worked on.
Example: unit #923 is shown as 23 on the schedule below, #813 is listed as 13, etc:
Examples of Scaffolding and Work:
Inside view of lanai wrapping for units being worked on:
